    $55.75 million Collective Training Officers Quarters Project at Fort McCoy now past 20 percent complete

    $55.75 million Collective Training Officers Quarters Project at Fort McCoy now past 20 percent complete

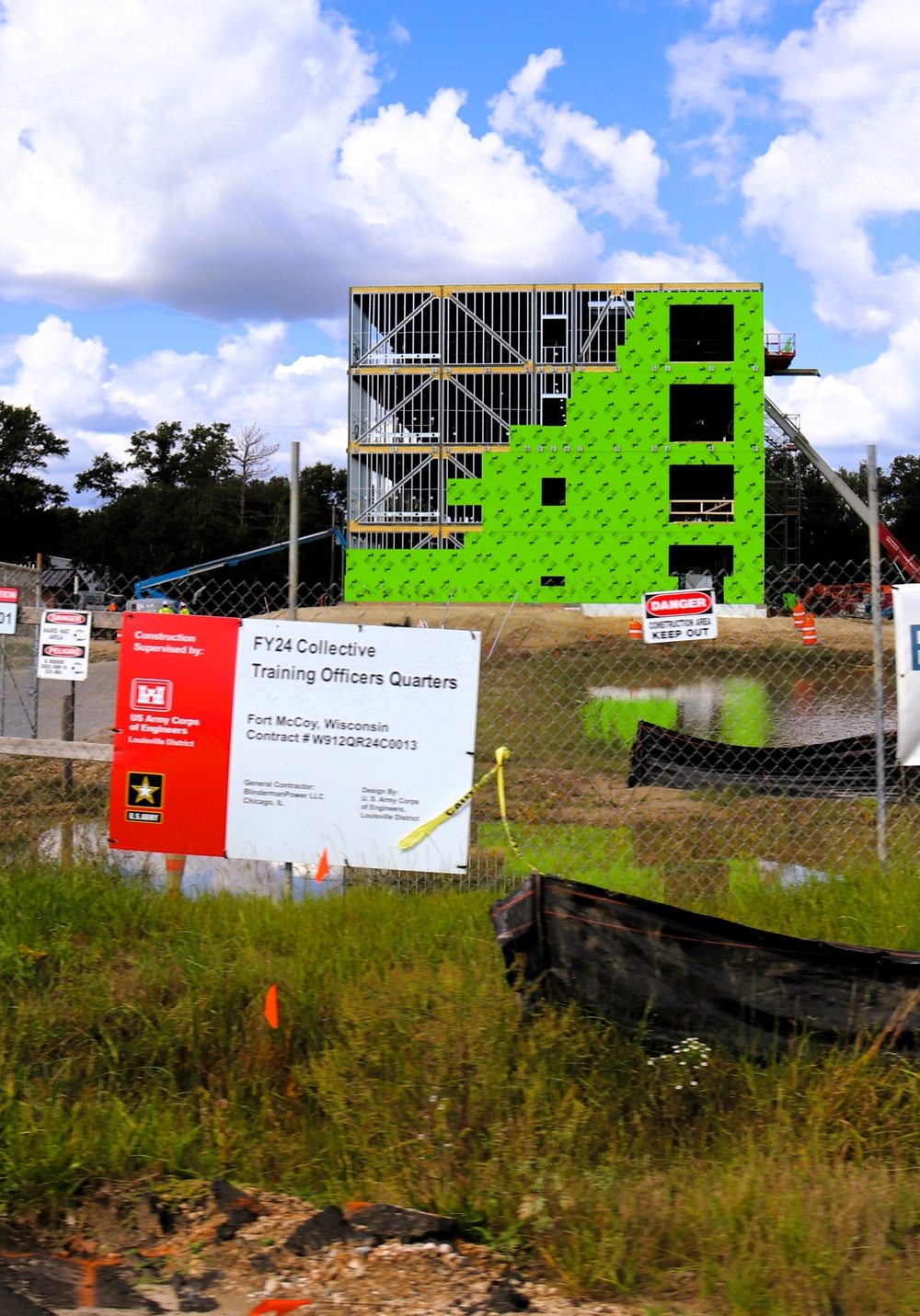

    Photo By Scott Sturkol | Contractors complete work Sept. 23, 2025, for the fiscal year 2024-funded $55.75...... read more read more

    The contractor for the $55.75 million Collective Training Officers Quarters Project at Fort McCoy has been busy finishing framing and more on one building and is set to soon erect steel framing on a second building as September comes to an end.

    The contractor for the project, BlindermanPower (Construction), which has also been working on another major project at Fort McCoy — the fiscal year-2022 funded South Barracks Project, was awarded a contract totaling $55,759,100, according to the Army Corps of Engineers, which is overseeing the project. The notice to proceed was acknowledged on July 19, 2024. The contract duration is scheduled for completion in 1,260 calendar days.

    For numerous months, actual full construction of the new buildings had to wait for another contractor to move five World War II-era barracks buildings. The project description in the contract states the plan is to build the two buildings based on the standard layout depicted in the Operational Readiness Training Complex.

    “This facility is required to replace antiquated World War II-era wood transient training officer quarters currently being utilized to train Soldiers during major exercises, annual training, battle assembly, and mobilization at Fort McCoy,” the description states. “This facility will be designed with the ability to be winterized or deactivated during the winter months.”

    Ken Green with the U.S. Army Corps of Engineers Resident Office at Fort McCoy said the project is now 22 percent complete and rising daily. In his Sept. 19 update, Green gave the latest actions.

    “Structural steel continued section B. Sleeve rough-in continued section B. Rebar was placed for elevated deck section B. Exterior wall framing continued section A,” Green wrote in the update.

    “Elevated slab placements continued sections A & B,” Green stated. “Imbeds spray foam started section A. Mechanical, electrical, and plumbing rough-in started. Exterior sheeting started in section A. And a truss package arrived on site.”

    The project description, also as stated in previous news articles, gives more information about how the project will continue to grow.

    “When Fort McCoy is not stood up as a mobilization platform, its primary mission is to support the seasonal requirements of training … Army Reserve Soldiers,” the description states. “In order to conserve as much energy as possible, while also decreasing the funding necessary to field extended utility costs, this building will be deactivated when it is not being used for training.”

    The contract requirements also show that work includes building a standing seam metal roof over rigid insulation on steel deck on structural trusses; using utility brick veneer over rigid insulation on steel studs with exterior glass mat gypsum sheathing; building a concrete floor on metal deck and on-grade; installing and elevator, aluminum doors and windows, gypsum board and metal frame partitions, steel door frames and steel doors, and acoustical ceilings; installing heating, ventilation, and air conditioning (HVAC) systems; completing plumbing, security, and electrical systems; and more.

    The officer’s quarters project makes three active, large construction projects taking place in the 1600 block of the installation. All this work also continues with the master plan for the 1600 block that will include not only the four barracks but also three 20,000-square-foot brigade headquarters buildings — one of which is done — and now the two 160-room officer quarters, said Fort McCoy Directorate of Public Works officials.

    See more news about the U.S. Army Corps of Engineers by visiting https://www.usace.army.mil/Media/News.

    Fort McCoy’s motto is to be the “Total Force Training Center.”

    Located in the heart of the upper Midwest, Fort McCoy is the only U.S. Army installation in Wisconsin.

    The installation has provided support and facilities for the field and classroom training of more than 100,000 military personnel from all services nearly every year since 1984.

    Learn more about Fort McCoy online at https://home.army.mil/mccoy, on Facebook by searching “ftmccoy,” on Flickr at https://www.flickr.com/photos/fortmccoywi, and on X (formerly Twitter) by searching “usagmccoy.”

    Also try downloading the My Army Post app to your smartphone and set “Fort McCoy” or another installation as your preferred base. Fort McCoy is also part of Army’s Installation Management Command where “We Are The Army’s Home.”
